What Actually Happens When You Start a Process Analysis

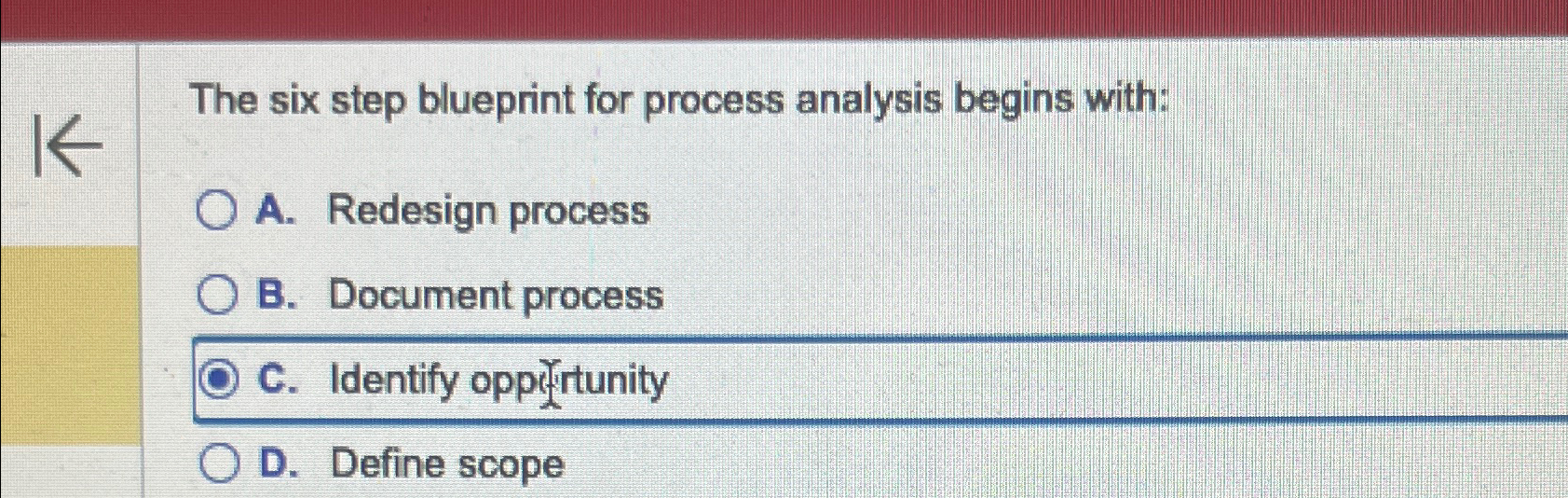

Most people rush into this and waste weeks because they don't stop at the first step long enough to do it right. I'm going to walk through how this actually works, why the opening phase determines everything else, and what I've seen go wrong in practice. Defining the scope and boundaries of what you're trying to analyze. It sounds obvious until you watch a team spend three weeks mapping a process and then realize they analyzed the wrong one because they never pinned down exactly where it started and where it ended. Before you draw a single flowchart or collect data, you need to answer three things: What process are we looking at? Where does it actually begin? Where does it end? This might sound elementary but in my experience it's where 80% of project scope creep originates. People say "customer service" and then nobody agrees whether that means the first call or the final resolution, and the entire analysis drifts from there.
How The Remaining Steps Unfold
Once you have scope locked in, the next steps typically move through mapping the current state, identifying bottlenecks and waste, analyzing root causes, designing the improved process, and finally implementing with controls to maintain gains. Each step depends on the one before it being solid. Skip the scope definition and every step after it inherits that ambiguity. The mapping phase should capture reality, not the version of the process that exists in someone's head or in outdated documentation. I learned this the hard way on a manufacturing line where we mapped the standard operating procedure and then compared it to what actually happened during a shift. They were completely different documents. The official SOP showed twelve steps. The real process had twenty-three, and the five missing steps in the documentation were the ones where the quality issues originated. If we'd only analyzed the documented version, we'd have fixed nothing.
Where This Approach Actually Breaks Down
Process analysis works best for stable, repeatable processes with clear inputs and outputs. It does not work well for highly variable knowledge work where the same task looks different every time, or for creative workflows where the output isn't predictable. Trying to force a six-step blueprint onto something like software development sprints or marketing campaign creation usually produces results that look good on paper and useless in practice. There's also a timing problem. If your process changes faster than your analysis can capture it, you're analyzing yesterday's reality. I worked on a support ticket workflow where the triage process was updated three times in two weeks while we were halfway through the mapping phase. By the time we finished, the documented process no longer existed. In situations like that, a lighter-weight approach like value stream mapping with shorter observation windows tends to be more practical than the full six-step cycle.
Get the Full Details

The Counter-Intuitive Part Nobody Talks About
Beginners tend to map everything they can see. Experienced analysts map less and look harder at what's invisible. The gaps between documented steps, the handoffs where information disappears, the delays caused by approval chains that no one wrote down. These are the places where value leaks out, and they rarely show up in a standard flowchart. Another thing that catches people off guard: the person doing the work and the person designing the process usually have completely different definitions of where the process starts and ends. The operator sees it starting when their hands touch the material. The manager sees it starting when the request comes in from somewhere else. Both are right. Both are wrong. Your scope definition needs to acknowledge both perspectives and explicitly choose which one the analysis will cover. If you try to satisfy both, your scope becomes so large the project stalls out.
A Practical Workaround From Experience
When I hit situations where stakeholders couldn't agree on boundaries, I started using a simple technique: I'd ask each person to write down the trigger that starts the process and the signal that it's complete, without consulting anyone else first. Then I'd compare the lists. Nine times out of ten, the discrepancies revealed exactly where the organizational handoffs were failing. The gap between what different people thought counted as "start" and "end" was usually the source of the problems they were trying to solve. I'd then document the agreed boundaries as a formal decision with signatures, not just an assumption everyone hoped was shared. That small act of making it explicit saved more projects than anything else in the analysis phase. The six-step blueprint works well for operational processes with measurable inputs, repeatable steps, and quantifiable outputs. It gives you something you can point at, measure against, and improve over time. If you're dealing with something more exploratory or strategic, a different framework like design thinking or lean startup loops might serve you better. Nothing here requires you to force every problem into this model. The first step is always the narrowest but the most consequential. Get it right and the rest flows. Get it wrong and you're measuring the distance between two points you never agreed on in the first place.
